Slurry/EPB Shields

Shield Tunnelling Machine Selection Guide: Ground Conditions, Diameter, and Slurry vs EPB

Shield tunnelling machine selection starts with ground conditions, diameter, and slurry vs EPB fit. Learn how to reduce risk, control costs, and choose the right system with confidence.
KHCFDC_头像  (1)
Time : Jul 06, 2026

Why does shield tunnelling machine selection affect more than excavation speed?

Shield Tunnelling Machine Selection Guide: Ground Conditions, Diameter, and Slurry vs EPB

A shield tunnelling machine is usually judged by progress rate first.

In practice, the bigger decision is fit.

If the machine does not match geology, groundwater, lining needs, and spoil handling, costs rise quickly.

That increase rarely appears only in the purchase price.

It shows up in cutter wear, slurry treatment load, chamber instability, settlement risk, and delayed segment installation.

This is why shield tunnelling machine selection is a project control issue, not a catalogue exercise.

A good selection process connects tunnel alignment, face pressure range, muck conditioning, logistics, and maintenance access.

That broader view matters even more in dense cities and long utility drives.

UTMD often frames underground equipment decisions through operating limits rather than brochure claims.

That approach is useful here.

The right shield tunnelling machine must work inside real constraints, including zero-emission support systems, digital monitoring, and restricted shaft logistics.

What ground conditions should shape the first shortlist?

Start with the ground model, not the machine family.

Mixed face conditions usually create the hardest decisions.

Uniform soft clay is one thing.

A face crossing sand, gravel, cobbles, and weathered rock is another.

The shortlist should be built around five site questions:

  • How stable is the face when pressure fluctuates?
  • What is the groundwater pressure and inflow risk?
  • How abrasive is the soil or rock mix?
  • Will boulders or sticky clay interrupt spoil flow?
  • How sensitive is the surface to settlement?

A shield tunnelling machine for stable fine-grained soils may perform poorly in high-permeability strata.

Likewise, a machine designed for aggressive slurry control can be unnecessarily complex for short, low-risk drives.

More common selection mistakes come from underestimating transitions between strata.

That is where production forecasts often fail.

The most useful technical dossiers include geotechnical variability, expected interventions, and spoil management assumptions.

Without those, shield tunnelling machine comparison becomes too generic to support real purchasing decisions.

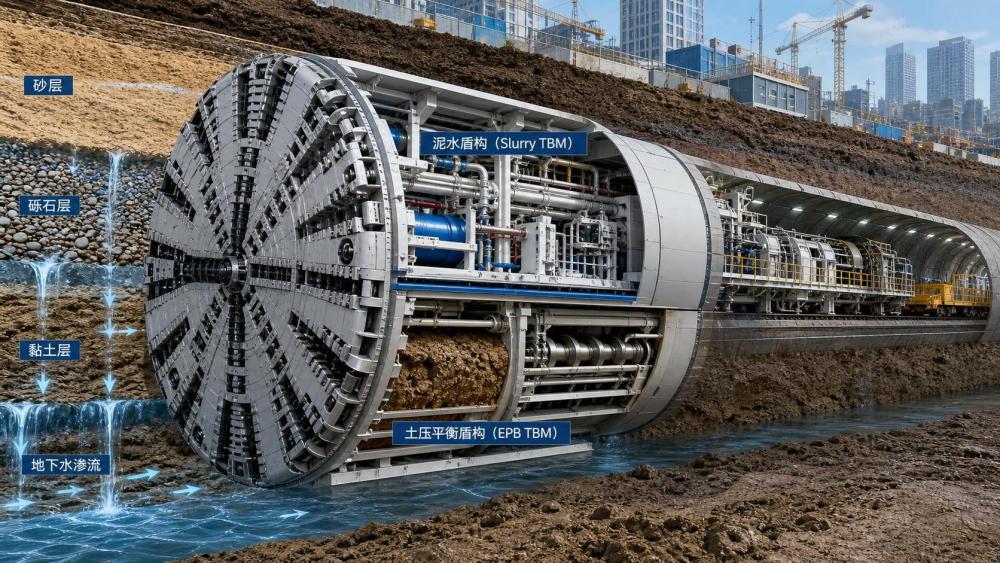

Slurry or EPB: which shield tunnelling machine makes more sense?

This is usually the turning point in the evaluation.

Both systems balance the tunnel face, but they do it differently.

A slurry shield tunnelling machine uses pressurized slurry to stabilize the face and transport excavated material.

An EPB machine uses conditioned spoil inside the excavation chamber as the pressure medium.

The practical choice depends on permeability, groundwater, fines content, and site logistics.

Decision point Slurry shield tunnelling machine EPB shield tunnelling machine
Best ground profile Water-bearing sand, gravel, high permeability soils Clays, silts, mixed soft ground with manageable conditioning
Face control Very strong under high groundwater pressure Good when spoil plasticity stays within target range
Surface footprint Needs slurry separation plant and fluid handling space Usually simpler site setup
Spoil management Higher treatment complexity Relies on foam, polymer, and screw conveyor performance
Typical risk Plant downtime, slurry circuit imbalance, disposal cost Clogging, pressure inconsistency, poor conditioning response

A simple rule helps.

When water pressure and permeability dominate the risk picture, slurry often wins.

When spoil can be conditioned into a stable plastic mass, EPB may offer a cleaner overall balance.

Still, no rule should override site data.

UTMD’s coverage of TBM performance trends repeatedly shows that auxiliary systems can decide the outcome as much as the cutterhead itself.

How should diameter and tunnel layout influence machine choice?

Diameter is not only a geometric requirement.

It changes torque demand, thrust load, segment handling, launch shaft size, and downstream transport needs.

Larger diameter often means greater technical margin is needed.

That affects both capital cost and operating discipline.

Three points are worth checking early:

  • Minimum curve radius and articulation requirements
  • Segment ring design, weight, and erector compatibility
  • Backup train length against shaft and tunnel logistics

A shield tunnelling machine can fit the excavation diameter yet still create problems underground.

This happens when the backup system is too long, power demand is underestimated, or segment supply cannot support the planned cycle.

In urban works, site access and spoil removal often become the hidden constraint.

In long drives, maintenance strategy becomes equally important.

The better comparison method is to assess the whole tunnelling system, not just the shield body.

Where do cost surprises usually come from?

Most budget overruns are linked to operating assumptions that looked minor during tender review.

The machine price is only one layer.

A shield tunnelling machine should be compared across life-cycle cost drivers.

That includes commissioning, consumables, interventions, training, spare parts, and surface support systems.

The following checks usually reveal risk faster than generic cost-per-meter estimates.

  • Expected cutter consumption under actual abrasivity, not average geology
  • Foam, polymer, bentonite, and water demand by ground section
  • Availability of intervention tools and hyperbaric capability
  • Separation plant uptime assumptions for slurry operations
  • Power supply, ventilation, and zero-emission support requirements

This wider lens fits current market conditions.

Underground projects now face tighter ESG targets, more digital reporting, and stricter site constraints.

UTMD tracks these shifts across tunnelling and mining equipment alike.

The shared lesson is clear.

Selection decisions are getting more system-oriented, more data-heavy, and less tolerant of optimistic assumptions.

What does a practical evaluation checklist look like before final selection?

A strong shortlist should answer a small set of hard questions before negotiation starts.

That keeps technical debate connected to commercial reality.

Evaluation item What to verify Why it matters
Ground fit Performance in mixed face, permeability, abrasivity, and clogging conditions Reduces face instability and unplanned stoppage
System layout Backup size, shaft fit, segment handling, spoil route Prevents bottlenecks after launch
Operations support Training, spare parts, remote diagnostics, condition monitoring Improves uptime and troubleshooting speed
Intervention readiness Cutter access, chamber entry method, safety procedures Controls high-cost maintenance events
Commercial realism Consumables, downtime allowances, warranty boundaries Makes bid comparison more honest

This is also the right stage to ask for reference cases with comparable geology.

Not every successful tunnel is a valid benchmark.

The most useful references match groundwater, tunnel length, and spoil behavior.

When those variables align, the shield tunnelling machine comparison becomes much more credible.

So, what is the safest next step before locking the order?

Bring the decision back to evidence.

A reliable shield tunnelling machine choice comes from matching geology, diameter, pressure control method, and site logistics in one review path.

That means the final decision should not rest on output promises alone.

It should reflect maintainability, intervention strategy, support systems, and long-term operating cost.

For complex projects, it helps to build a side-by-side matrix using real geotechnical sections and expected operating windows.

That makes slurry versus EPB trade-offs much clearer.

It also reduces the chance of selecting a machine that looks competitive only at tender stage.

Where market intelligence is needed, UTMD’s broader view of TBMs, trenchless equipment, and underground system transitions is useful for checking assumptions against current industry patterns.

The next practical move is straightforward.

List the tunnel sections by risk, compare slurry and EPB performance against those sections, then test each shield tunnelling machine option against total system cost, intervention exposure, and schedule resilience.
