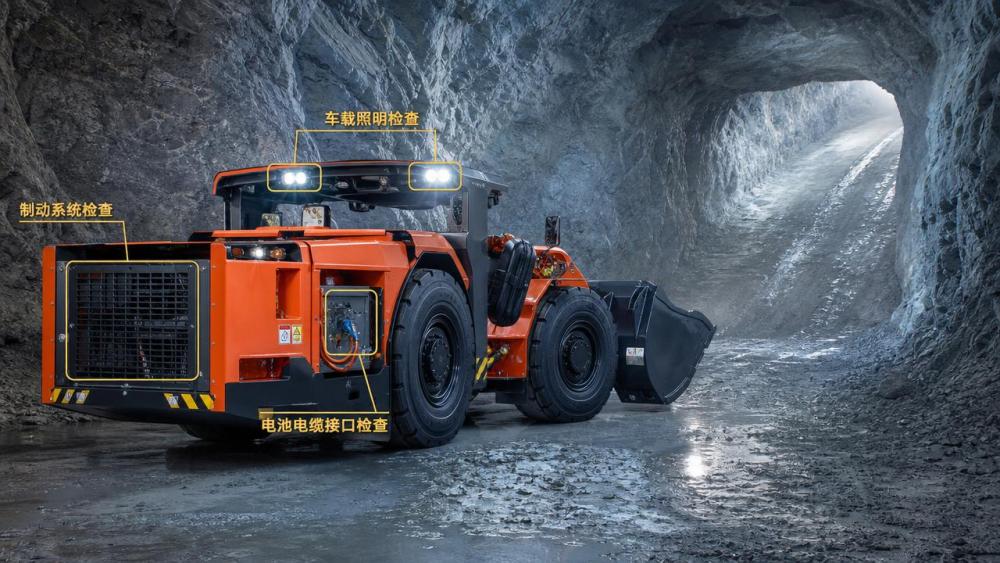

Underground LHD Loaders often fail safety checks not because of one obvious defect, but due to a chain of issues involving braking systems, visibility limits, electrical safety, battery performance, and operator-assist controls. For quality control and safety managers, understanding these failure points is essential to reducing downtime, preventing incidents, and ensuring compliance in demanding underground mining environments.
In modern underground mining, an LHD loader works in headings with limited clearance, wet floors, sharp gradients, and airborne dust. Under these conditions, even a minor fault can trigger a failed inspection, a production delay of 4 to 12 hours, or a shutdown of an entire loading zone.
For UTMD readers responsible for quality control, safety assurance, and operational readiness, the key issue is not only why Underground LHD Loaders fail safety checks, but how to identify weak points early, verify corrective actions, and reduce repeat non-conformities across mixed diesel, electric, and battery-powered fleets.

Most failed inspections can be grouped into 5 core systems: braking, steering, visibility, electrical integrity, and emergency response functions. In practice, failures rarely appear in isolation. A machine with weak service brakes often also shows hydraulic leakage, delayed alarm response, or poor tire and axle condition.
On underground ramps, braking systems are tested under harsher conditions than in surface equipment yards. Safety checks usually assess service brakes, parking brakes, emergency stopping response, and brake line condition. A stopping delay of even 1 to 2 seconds can be enough to trigger a non-compliance finding on a loaded machine.
Common causes include worn pads, hydraulic contamination, overheating during repeated downhill cycles, and insufficient pressure retention after shutdown. For battery-electric Underground LHD Loaders, inspectors also review how regenerative braking interacts with mechanical braking, especially on long declines where thermal buildup can occur after multiple haul cycles.
As mines adopt tele-remote and semi-autonomous loading, visibility checks have moved beyond windshield cleanliness and lighting output. Inspectors now review camera coverage, monitor latency, blind-zone alerts, reversing alarms, beacon operation, and sensor contamination from mud, dust, and water spray.
A loader may pass a static inspection yet fail a functional safety check if the camera image lags by more than a fraction of a second, if side illumination is inadequate in cross-cuts, or if object-detection sensors misread reflective surfaces. In headings under 5 meters wide, these problems become high-priority risks.
The table below outlines frequent failure points that quality and safety teams should verify during pre-acceptance checks, daily inspections, and post-maintenance release testing.
The key takeaway is that safety failures usually sit at the intersection of mechanical wear and control-system reliability. For Underground LHD Loaders, passing inspection depends on proving that all linked systems perform consistently, not just that a single component appears serviceable.
With more electric and battery-swap fleets entering underground operations, inspectors have expanded checks on high-voltage isolation, cable routing, charger interface protection, grounding continuity, and thermal events around enclosures. These checks are especially strict where humidity remains high for 8 to 16 hours per shift.
Safety managers should pay close attention to cable chafing near articulation points, degraded sealing around battery packs, and contamination in plug interfaces. Even if the machine is still productive, these issues often fail formal release checks because they elevate fire or electric shock exposure in confined spaces.
The underground environment accelerates hidden degradation. Water ingress, vibration, shock loading, and repeated thermal cycles create faults that may not be visible during routine walkarounds. Underground LHD Loaders working 2 or 3 shifts per day accumulate wear much faster than standard service intervals sometimes assume.
A loader operating on a 400 to 800 meter haul route may brake, reverse, articulate, and dump dozens of times per shift. Under these cycles, a component rated for a nominal interval can still fail early if haul gradients are steep, muck density varies, or operators regularly make abrupt directional changes.
This is why some Underground LHD Loaders fail safety checks shortly after scheduled service. The issue is not always poor maintenance quality; often the original service plan does not reflect actual duty severity, road condition, or the thermal profile of electrified drivetrains in stop-start production headings.
Earlier safety checks focused mainly on structural condition and hydraulics. Today, they also examine speed limiting logic, traction control, interlocks, diagnostic reporting, and fail-safe behavior after communication loss. A loader can be mechanically sound and still fail because the system does not transition safely when a sensor drops offline.
For tele-remote Underground LHD Loaders, signal stability matters. If command latency spikes during handover between underground network zones, or if camera feeds degrade under dust loading, safety functions may no longer meet mine acceptance criteria. These are difficult failures because they may only appear during live operational testing.
The following matrix helps QC and safety teams connect site conditions with likely inspection failures before the loader enters production.
This table shows why one mine may see repeated electrical failures while another struggles mainly with braking or visibility. The failure pattern usually reflects route design, ventilation quality, water management, and how the site combines automation with manual operation.
Reducing failed checks requires a structured approach before the machine reaches the shift line. Effective sites do not rely on annual audits alone. They build a layered process covering incoming inspection, pre-shift verification, post-maintenance testing, and trend review every 2 to 4 weeks.
A practical release model includes four stages. First, verify mechanical integrity after maintenance. Second, confirm electrical and control-system health. Third, perform a functional test under load or simulated load. Fourth, document sign-off with defect coding so recurring issues can be tracked by component and by operating zone.
This process is especially useful for battery-electric Underground LHD Loaders, where a machine may appear ready after charging or battery exchange but still carry unresolved issues in thermal management, isolation alarms, or software interlocks. Release discipline can prevent avoidable rejections within the first 24 hours of return to service.
Many operations record inspection outcomes but do not analyze recurring failure patterns. A better method is to track top 10 defect types by machine hours, location, and shift. Over a 30 to 90 day period, this reveals whether failures are tied to one route, one maintenance team, one battery bay, or one operator group.
For example, if 35% of rejected Underground LHD Loaders show lamp, camera, or alarm faults after wet-season weeks, the problem may be enclosure sealing or cleaning practice rather than component quality alone. Trend analysis turns safety inspections from a compliance exercise into a prevention tool.
Procurement teams often compare payload, battery runtime, and turnaround time first. Those metrics matter, but quality and safety managers should also specify access for inspection, clarity of fault diagnostics, emergency isolation design, and maintainability of brake and visibility systems. These details strongly affect pass rates over the first 6 to 12 months.
When evaluating new Underground LHD Loaders, ask whether the machine supports clear event logs, fast sensor replacement, protected cable routing, and practical cleaning access for cameras and lamps. Safety performance in underground mines depends as much on serviceability as on headline machine specifications.
The most effective safety programs connect procurement, maintenance, operations, and OEM support. If those groups work in separate silos, failed checks will continue to repeat. The goal is to create a shared acceptance language around braking consistency, electrical integrity, visibility coverage, and control-system fail-safe behavior.
A frequent mistake is treating every failed safety check as an isolated maintenance lapse. In reality, repeated failures in Underground LHD Loaders usually point to a system-level mismatch between machine design, route conditions, servicing method, and operating discipline. Unless all four are reviewed together, corrective action stays temporary.
Underground LHD Loaders fail safety checks when multiple small weaknesses combine under real mine conditions: heat, water, restricted space, heavy cycle counts, and increasing dependence on electronics and remote controls. For quality control and safety managers, the most effective response is a structured inspection regime, defect trend analysis, and procurement criteria that prioritize verifiable safety performance over brochure-level claims.
UTMD tracks the technical evolution of underground haulage systems, from battery-swapping architecture to SLAM-enabled navigation and braking efficiency on decline routes. If you need deeper guidance on evaluating Underground LHD Loaders, comparing safety-critical configurations, or building a more robust inspection framework, contact us now to get a tailored solution and explore more underground equipment intelligence.
